Patriot Docks kit guide

How to Install a Floating Dock Kit

From pallet to water: assembling a Patriot floating kit near the shore, launching it by hand, and getting it ready to anchor.

By Shoreline ProductsUpdated 7 min readChecked against Patriot Docks Floating Dock Assembly Instructions, 2026 edition

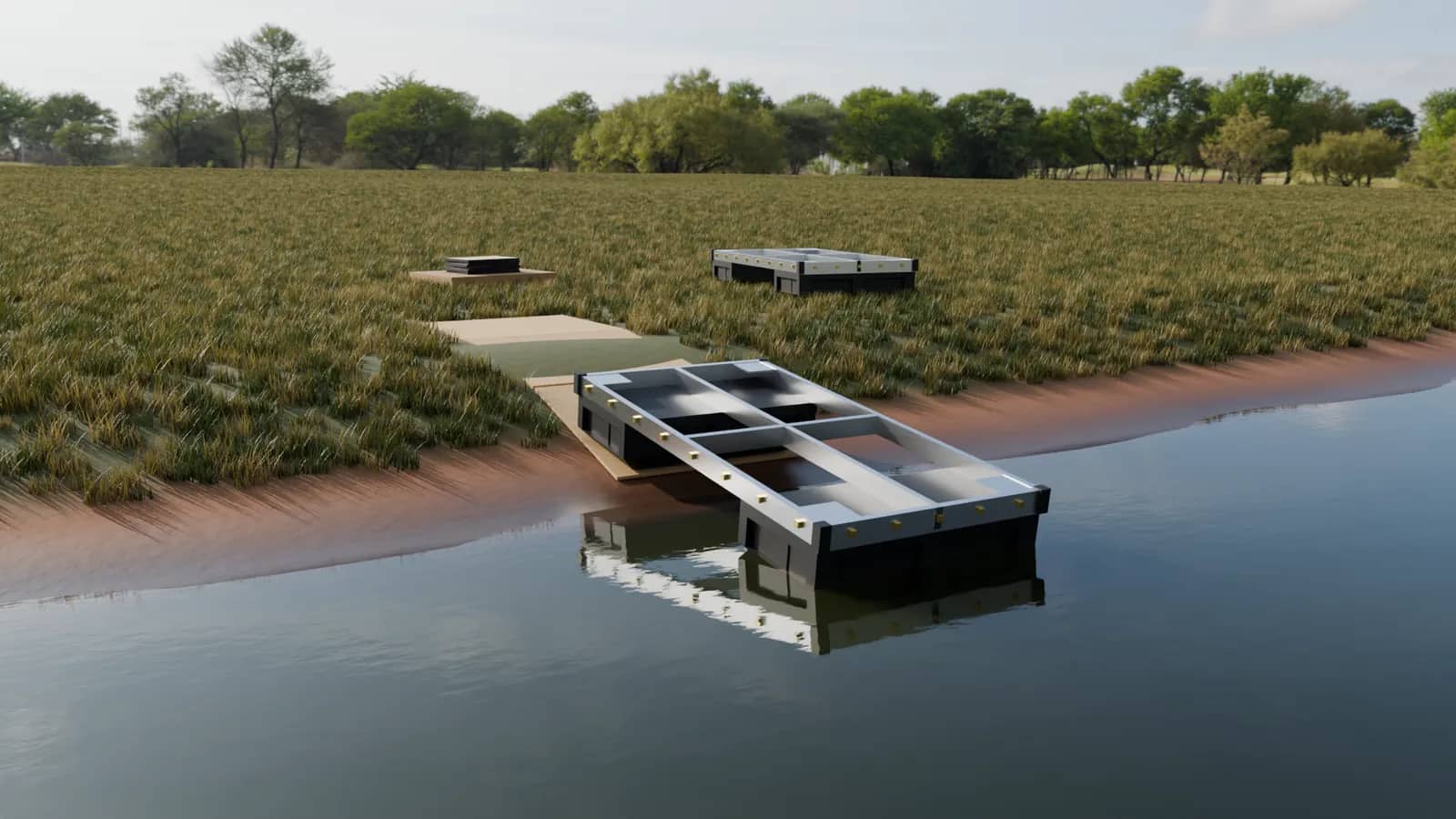

Patriot floating dock sections without decking at the edge of a Texas pond: one sliding into the water over a plywood path, another assembled on the grass, and decking panels stacked on a pallet
Illustration: sections built at the water's edge with the decking off, then put in one at a time.

The short answer

A Patriot floating kit goes in with hand tools and at least two people, and no machinery to move it. Unload the pallet by hand, then bolt the frames together close to the water with the decking left off: about 30 minutes per 4 by 8 ft frame. Carry each section into the water one at a time, or slide it over plywood where the ground is rough. Bolt each new section on at the water's edge and push the dock out, set the 8 ft ramp on the bank, and hold the dock with temporary lines. Then lay the decking, anchor the dock from the deck, and check every bolt. Everyone on the dock or in the water wears a life jacket. Pick a calm morning.

  • 2+people to move it and set it in the water
  • 30 minto bolt each 4 by 8 ft frame
  • Nomachinery or winches to move it
  • Decking offuntil the dock is floating and in place

What do you need before you start?

The pallet unloaded, the tools out, the anchoring parts on site, and at least one helper for launch day.

  • Delivery: the kit comes on a 4 by 8 ft pallet on a semi-truck, and the carrier calls ahead. If a semi can't get down your road, you meet the driver where it can park. Note any damage on the paperwork before you sign. The truck can't lower the pallet, so you and a helper unload it piece by piece into a pickup or trailer: about 10 to 25 pieces, none over 50 lb, in 5 to 15 minutes.
  • In the box: the frames, floats, decking, the 8 ft ramp, four piling sleeves, and the bolts and hinges that join it all, plus a few extra bolts on purpose. Check it against your packing slip.
  • Not in the box: the anchoring (pipe and augers, or chain and weights), extra sleeves or floats, plywood, rope and stakes, and life jackets.
  • Tools: a cordless drill, a rubber mallet, gloves, #2 and #3 Phillips drivers, a 3/8 in Allen key (9 mm), and sockets or wrenches in 3/8, 9/16, 5/8, 11/16 and 23/32 in, or 10, 14, 15, 17 and 18 mm. Many basic sets lack the 15 mm and 23/32 in. Also have a tape measure, a level and a marked depth pole.
  • Anchoring: have it on site before launch day. See our anchoring guide.
  • Permits: a private stock tank usually needs none, but lakes run by a river authority, a city or the Corps of Engineers usually need a dock permit. Check any HOA rules too.

How does your shoreline change the job?

The bank decides how you launch.

Launching by shoreline
ShorelineWhat to do
SandThe most forgiving. Carry the section close to the water and let the floats take over.
GravelLay plywood, tarps or moving blankets so the floats never drag on stone.
RockCarry each section clear of the rock, or slide it over plywood. Sharp rock can damage a float.
Soft mud edgeLay plywood out to firm footing. Don't wade deeper than your knees to push off.
Steep bankThree people. Tie a rope to the frame, not a float, take a turn around a tree or post above it, and let the section down slowly while two people steady it from the sides. Nobody below it.

How do you assemble it?

Build each section where it will slide into the water, with the decking off.

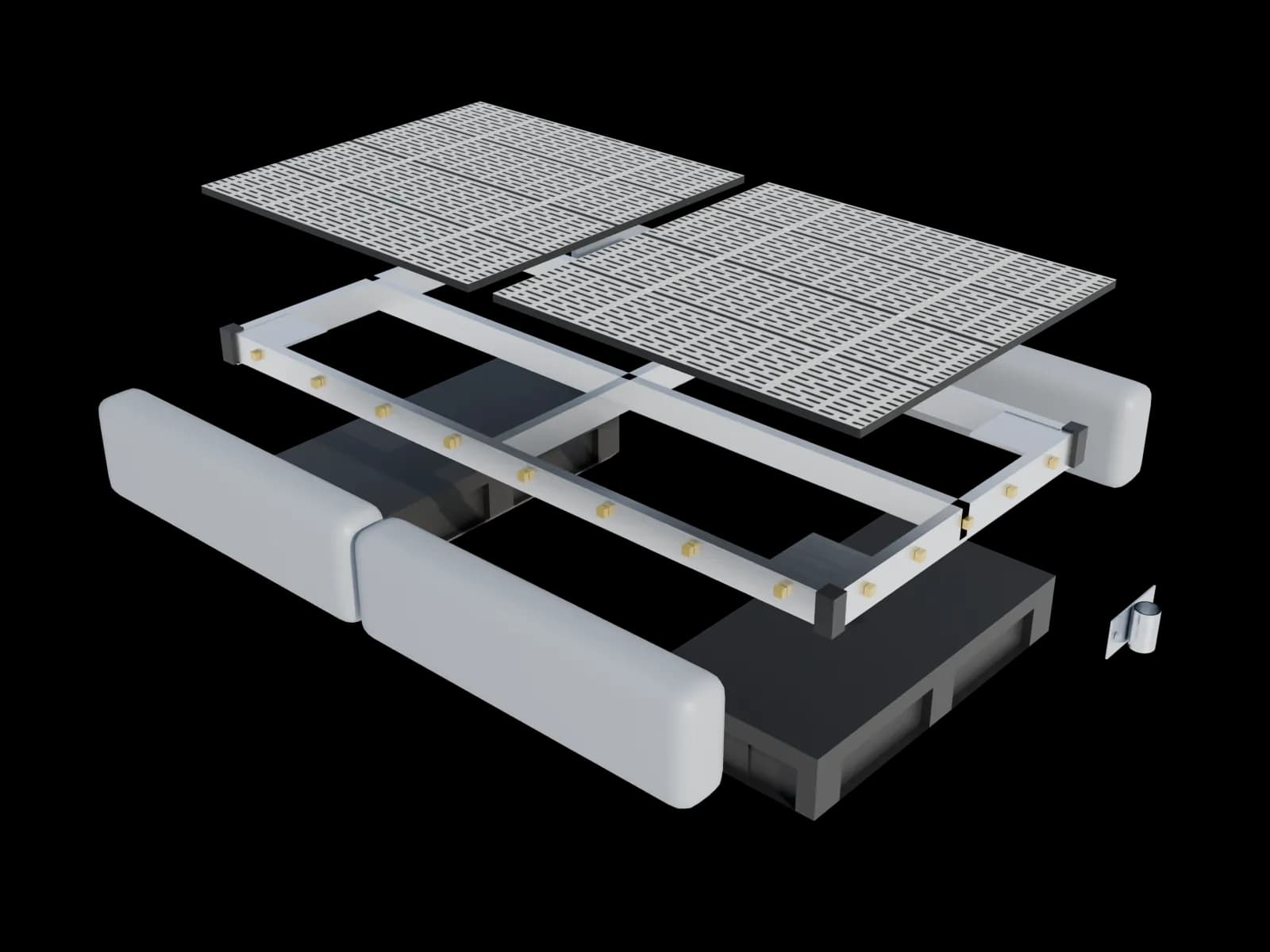

Exploded illustration of one Patriot premium floating section: two deck panels above the aluminum frame, two black floats below it on J-bolt hardware, two gray side stability floats along each long side, and a piling sleeve
  1. 4 by 4 ft deck panels, two per section
  2. 4 by 8 ft aluminum low-profile frame
  3. Two 24 by 48 by 12 in floats on J-bolt hardware
  4. Side stability floats, premium kits only; not a step
  5. Piling sleeve; bolts to the 4 ft end of a frame or the middle of a long side
Illustration: what one 4 by 8 ft premium section is made of.
  1. Lay out the parts near the water

    On level ground at the water's edge, on the line you'll launch along. Build sections, not the whole dock: Patriot calls assembling the entire dock far from the shoreline one of the most common mistakes, and suggests building larger docks one section at a time.

  2. Bolt the frame

    Hand-tighten every bolt first. Measure both diagonals; when they match, the frame is square. Then tighten with a wrench. About 30 minutes per frame.

  3. Attach the floats

    Two under every 4 by 8 ft frame, fastened with the J-bolt kit as Patriot's manual shows.

  4. Add side floats and sleeves

    Premium side floats bolt along the outside edges; they're not a step. Bolt the piling sleeves where your anchoring plan puts them: our anchoring guide shows a typical start.

  5. Leave the decking off

    It goes on once the dock is floating, tied off and in position, so you can set the far anchors from the deck. Until then, don't stand on the bare frame rails.

How do you launch it?

By hand, one section at a time, letting the water take the weight as early as you can.

  • Carry it. Patriot puts a finished 8 ft section at about 150 lb with its decking, and calls a single section manageable for many homeowners. With the decking off, it's a carry for two or three people.
  • Slide it on plywood over gravel, rock or a long haul, moving the back sheet to the front as you go, so the floats ride on wood instead of stone.
  • Never drag the floats across rough ground; put tarps or blankets under them if you have to.
  • Let the water help. Once the floats reach the water, it starts carrying the load; float the section the rest of the way.
  • Go early. Patriot's example: a launch that takes half an hour on a calm morning can get frustrating in strong afternoon wind.

How do the sections go together on the water?

Far end first. Bolt each new section on at the water's edge, where you can stand, then push the dock out.

Install site plan for a floating dock kit Top view of a shoreline. Sections are assembled near the water with the decking off, carried or slid over plywood into the water, joined at the water's edge and pushed out, and connected to the bank by the ramp. Temporary lines from each side of the far end to stakes on both sides hold the dock until it is anchored, with a pair of anchor points near the shore end and a pair at the far end. 1243561Assemble near the water, decking off2Carry it in, or slide it on plywood over rough ground3Join sections at the water's edge, then push out4Set the ramp on the bank5Temporary lines to stakes, one each side6Anchor it, then take the lines off
Assemble at the water, launch along one path, join at the water's edge, and hold it with temporary lines until it's anchored.
  1. Hinge or bolt each joint

    A hinge where the ramp meets the dock and about every 16 ft after; the other joints bolt rigid with the 4 in bolt kit.

  2. Square up any platform

    Patio, T-shaped and double patio frames bolt side by side. They're the far end, so they go in first.

  3. Set the ramp

    Hinge the 8 ft ramp to the first section. Its shore end stands on two short adjustable legs: set them on firm ground and adjust them so the ramp sits level side to side. If the first section rides low under the ramp, add an extra float under it (not in the kit).

How do you hold it in place and anchor it?

Tie it off, lay the decking, then anchor it from the deck.

  • Tie it off with a line from each side of the far end to a tree or stake on each side of the bank, so wind from either side can't push it off line.
  • Check the spot: depth under the first float, distance from shore, and room for your boat. Moving it now is easy.
  • Lay the decking. Work out from the ramp, standing only on panels you have already set and locked. Set the 4 by 4 ft panels and lock them the way Patriot's instructions show for your decking; poly and aluminum have their own sheets, linked above.
  • Anchor it, then remove the lines. Set the shore pair standing in shallow water and the far pair from the decked dock or a boat, never from bare frame rails or deep water. Our anchoring guide covers both systems.

How do you finish it?

Walk the dock with a checklist.

Before anyone uses it, check that:

  • Every bolt is tight, except any set screws on the piling sleeves: leave those loose
  • Every section is connected
  • Hinges and the ramp move freely
  • Each sleeve slides freely on its pipe, or each chain has slack
  • The temporary lines are gone
  • The dock sits level

How long does it take?

Bolting is quick; launching, connecting and anchoring take the time.

Patriot's install time estimates
JobTime
Bolting one 4 by 8 ft frameAbout 30 minutes
Bolting a 32 ft straight dockAbout 2 hours
Installing a single section3 to 5 hours
A small residential dock5 to 10 hours
A medium dock system1 to 2 days
A large multi-section dock2 days or more

Patriot gives these times for most homeowners and says to plan for at least two people and calm weather. It doesn't define small, medium or large. Allow extra time for shoreline prep and anchoring.

Would you rather have a crew do it? Our custom docks are engineered for your site and installed for you.

Quick answers

Can one person install a floating dock kit?

One person can bolt frames together on land. Plan on at least two people to move and launch it, and three on a steep bank.

Can I use a tractor or a winch to launch it?

No. Patriot's instructions say machinery and winches can damage the dock, and damage from any install not done by hand voids the warranty. Launch by hand, one section at a time.

Should the decking go on before launching?

No. Launch the frames and floats, then lay the decking once the dock is floating, tied off and in position, so you can set the far anchors from the deck.

How long does it take to install a floating dock?

For most homeowners, Patriot puts a small residential dock at 5 to 10 hours, a medium system at 1 to 2 days, and a large multi-section dock at 2 days or more, with at least two people. Bolting one frame takes about 30 minutes. Anchoring is extra.

Sources

Shoreline Products sells and supports Patriot Docks kits; Patriot Docks builds them. Figures attributed to Patriot come from its published instructions and articles.
